Construction Surveyor Control for Podium Apartments Over Shared Parking

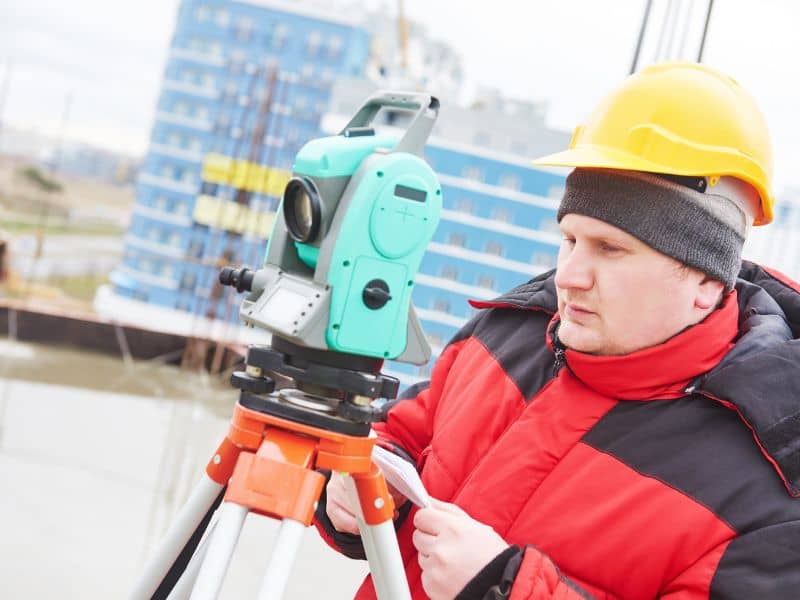

Fort Worth Land Surveying Posted on October 12, 2026 by Fort WorthSurveyorOctober 8, 2026
Construction surveyor using a total station for podium apartment construction in Fort Worth, Texas

A podium apartment building is really two buildings stacked on top of each other. The concrete parking structure below follows one set of rules, and the wood or light-gauge framing above follows another. Where those two meet, a small layout error can turn into weeks of rework.

A construction surveyor keeps both structures tied to the same reference system so columns, walls, and shafts land where the plans say. This guide is written for developers and general contractors, with notes that engineers and framers will find useful too. Set control early, check it often, and verify the podium slab before anyone frames on top of it. Those three habits prevent most layout problems on podium jobs.

Establishing Survey Control for Podium Apartment Construction

Survey control is a network of fixed points with known positions and elevations. A construction surveyor establishes survey control points before work begins, and every later layout ties back to them. If the control is weak, everything built from it inherits that weakness.

On a podium job, the network has to serve two very different crews. Concrete contractors need it for columns, ramps, and slabs. Framers need it months later for walls, stairs, and elevator shafts several stories up. Points placed where they’ll be paved over or blocked by shoring won’t survive that long.

Primary control is usually set outside the work zone, with secondary points added closer to the building. The network should match the coordinate system and benchmark shown on the civil plans. Datum and tolerance requirements can vary by engineer, project scope, and municipality, so confirm them before mobilization.

Aligning Parking Structure Gridlines With Residential Building Layouts

Gridlines are the lettered and numbered lines on structural drawings that locate columns and walls. In a podium building, the parking grid and the residential grid often don’t match. Parking bays favor wide column spacing for cars, while apartment units follow a tighter rhythm based on room sizes.

Before layout starts, the construction surveyor should compare the structural, architectural, and civil drawings side by side. Both grids need to share the same origin point and rotation. A grid that’s off by a fraction of a degree can push upper walls several inches out of place across a long building.

When conflicts show up, they should go to the design team through an RFI before concrete is placed. A surveyor shouldn’t guess which drawing is correct. The right move is to flag the issue, document it, and lay out only from approved information.

Verifying Podium Slab Elevations Before Upper-Level Construction

The podium slab is the transfer deck between the parking levels and the apartments. Its elevation affects floor heights, door thresholds, plumbing slopes, and total building height. If the slab comes in high or low, every level above carries that error.

An as-built survey of the slab gives the team real numbers instead of assumptions. The surveyor shoots elevations on a grid across the deck and at critical spots like shaft openings, stair landings, and wall lines. Post-tensioned slabs can shift slightly after stressing, so many teams check after the pour and again after stressing.

Share the results with the framer and structural engineer before upper-level work starts. Small differences can often be handled with shims or adjusted sill plates. Larger ones may need an engineering review, and it’s far cheaper to learn that before the first wall goes up.

Maintaining Horizontal and Vertical Control Across Construction Phases

A podium project can run well over a year, and control points take a beating in that time. Equipment bumps them, crews bury them, and settlement can move them. A construction surveyor has to keep checking the network so small errors don’t stack up from one phase to the next.

Horizontal control is usually carried up through floor penetrations or set as offset lines from exterior points. Vertical control moves up with benchmarks on each level, checked against the original site benchmark. Every transfer should close back to known points, because a single unchecked transfer can drift without anyone noticing.

Keep a simple control log that records which points were set, checked, disturbed, or reset. That record helps when a subcontractor questions a layout or an owner wants proof the work matched the plans. It also makes handoffs easier when different crews cover different phases.

Checking Structural Alignment Where Parking and Residential Levels Connect

The connection between the podium and the framing above is where many problems show up. Elevator shafts, stair cores, plumbing stacks, and bearing walls all have to line up through both structures. A shaft that’s off by an inch at the podium can cause real trouble for the elevator installer later.

Before framing begins, the construction surveyor should check embedded items in the slab against the plans. That includes anchor bolts, hold-down hardware, sleeves, and shaft openings. Concrete cores should be checked for plumb too, since framers will build tight against them.

Bring those findings to a short coordination meeting with the framer, MEP trades, and superintendent. Each trade can see where adjustments are needed before materials are cut. That small step keeps the transition between structures from becoming the slowest part of the schedule.

Frequently Asked Questions

What does a construction surveyor do on a podium apartment project?

A construction surveyor sets the control network, lays out gridlines, and checks that work matches the plans. On podium jobs, that work covers both the concrete parking levels and the framed apartments above. The surveyor also performs as-built checks at key stages. This helps catch errors before they spread to later phases.

When should the podium slab be surveyed?

Most teams survey the podium slab right after it’s poured and cured enough to walk on. Post-tensioned slabs are often checked again after stressing. The final check should happen before framers begin layout. Your engineer may set specific timing, so confirm it early.

How accurate does survey control need to be?

Accuracy requirements depend on the project specs, the structural engineer, and the type of work being placed. Elevator shafts and embedded hardware often need tighter tolerances than general site work. Your surveyor should review the specs before setting control. Ask for the tolerances in writing so every trade works to the same standard.

Can one control network serve the whole project?

Yes, one network should serve the whole project, but it needs regular checks and maintenance. Points get disturbed, buried, or blocked as the building rises. The surveyor will reset or replace them as needed and tie the new points back to the original system. A control log keeps that history clear.

Who should receive the survey results?

The general contractor, structural engineer, and affected trades should all see the results. Framers and elevator installers care most about podium slab and shaft data. Owners and lenders may also want as-built records for their files. Sharing results early gives everyone time to plan adjustments.

Posted in construction | Tagged construction survey

Survey Mapping for Campus Expansions Across Multiple Downtown Blocks

Fort Worth Land Surveying Posted on October 5, 2026 by Fort WorthSurveyorSeptember 30, 2026
Survey mapping for campus expansion across multiple downtown blocks in Fort Worth Texas

Campuses that grow one block at a time often end up with a stack of surveys that don’t agree. One parcel was mapped from an old plat, another on a different datum, and a third by a firm that closed years ago. Survey mapping solves this by tying every block to one shared base map. Universities, hospitals, and other owners planning growth across several blocks should set up that system before design starts and keep it current through every phase.

Building One Survey Framework Across Multiple Blocks

Good survey mapping starts with a framework. That means one coordinate system, one vertical datum for elevations, and a network of control points that ties all the blocks together. Control points are marked spots with known positions and elevations. Every later survey ties back to them, so a sidewalk drawn on one block meets the curb on the next. Before fieldwork starts, agree with your survey team on these basics:

  • The coordinate system and vertical datum for all drawings
  • Accuracy standards for boundary, topographic, and utility work
  • CAD layer names and file formats the design team needs
  • How past surveys will be checked and brought in

Older surveys still have value. Your surveyor can compare them to the new control and record where they differ. That note saves hours when someone later asks why two maps don’t match.

Mapping Property Boundaries and Rights Across the Campus

Boundary mapping shows where campus property boundaries end and what rights others hold on it. Many campuses are pieced together from parcels bought over decades, and each deed may describe its lines a bit differently. The surveyor researches deeds, plats, and recorded easements, then finds monuments in the field. The result is one map showing every parcel line, gap, overlap, and encumbrance.

Watch for utility easements, access agreements, shared walls, and air rights over sky bridges. Any of these can limit where you build. If the plan depends on closing a street or alley, the survey should show the right-of-way lines and the utilities inside them. Closure rules vary by city, and approval can take months, so start early.

Have the boundary work checked against a current title commitment. Lenders and title companies may ask for an ALTA/NSPS survey on some parcels, and those needs vary by deal. Sorting this out early keeps it from slowing a closing or permit review.

Connecting Existing Conditions for Campus-Wide Site Planning

Existing conditions mapping records what’s on and under the ground across the whole campus today. That covers buildings, curbs, trees, grades, drainage structures, and utilities. With every block on the same control, planners can follow a walkway, storm line, or service route from one end of campus to the other. Gaps between separate surveys go away.

Downtown blocks are crowded underground. Water, sewer, gas, power, telecom, and sometimes steam lines cross under streets and between buildings, and old records are often wrong. Ask about a subsurface utility engineering (SUE) investigation when foundations, tunnels, or major utility work depend on exact locations.

Elevations matter just as much. Small grade changes between blocks can send stormwater the wrong way after new paving goes in. Spot elevations at doors, curbs, and inlets help your civil engineer plan drainage and accessible routes.

Maintaining Survey Control as Campus Construction Expands

Construction tends to destroy the control points a project depends on. Excavation, crane pads, and new paving often land right on top of them. On a multi-year campus build, lost control means each phase can drift from the last.

Ask your surveyor to set extra points outside likely work zones, such as on stable building corners or across the street. Check the network on a set schedule and after major site work. Keep a control log listing each point, its coordinates, and its condition, and share it with every crew on campus.

This pays off when phases connect. A new building may need to meet a tunnel or plaza built years earlier. Construction staking from one stable network keeps those tie-ins tight and cuts down on rework.

Updating Survey Mapping as Expansion Plans Change

Campus plans shift. Funding changes, a nearby parcel goes up for sale, or a building’s program grows. Your survey mapping should grow with the plan instead of starting over each time.

After each phase, collect as-built data showing what was actually built, including utilities, grades, and structures. Fold it into the master base map using the same control and standards. The next design team then starts from real conditions instead of old plans.

When the campus adds land, extend the control network and boundary mapping to cover it. Check the new deed against adjoining campus parcels. If a closing, permit, or construction start depends on the survey, confirm the scope early, since requirements vary by city, county, lender, and project.

Frequently Asked Questions

What is survey mapping for a campus expansion?

It’s the process of building one accurate base map that covers every block in the expansion area. The map combines boundaries, easements, existing conditions, and utilities on a shared coordinate system. Designers, engineers, and contractors all work from it. This keeps drawings from different phases and firms lined up.

How often should campus survey control be checked?

There’s no single rule, but most teams check control before each new phase and after major earthwork. Long projects may add checks every few months. Your surveyor can suggest a schedule based on how much ground disturbance is planned. Any point that looks bumped or buried should be checked before it’s used.

Does every campus parcel need an ALTA survey?

Not always. ALTA/NSPS surveys are usually tied to a purchase, sale, or loan, and the lender or title company sets the scope. Parcels the campus already owns may only need boundary and existing conditions work. Confirm with your title company and lender before ordering.

Can we reuse surveys from earlier campus projects?

Often, yes, as long as they’re checked first. A surveyor can tie older work to the current control and note any shifts or errors. Some data, like utility locations or grades, may be outdated and need fresh fieldwork. Reusing what still holds up can save time and cost.

When should we bring a surveyor into campus planning?

Bring one in before master planning moves into design. Early survey work sets the control, clarifies boundaries, and flags rights or utilities that could change the plan. Waiting until permits are near often leads to redesign. A short early meeting usually costs far less than a late surprise.

Posted in land surveying

Land Survey Company Support for Replats That Create Separate Commercial Pad Sites

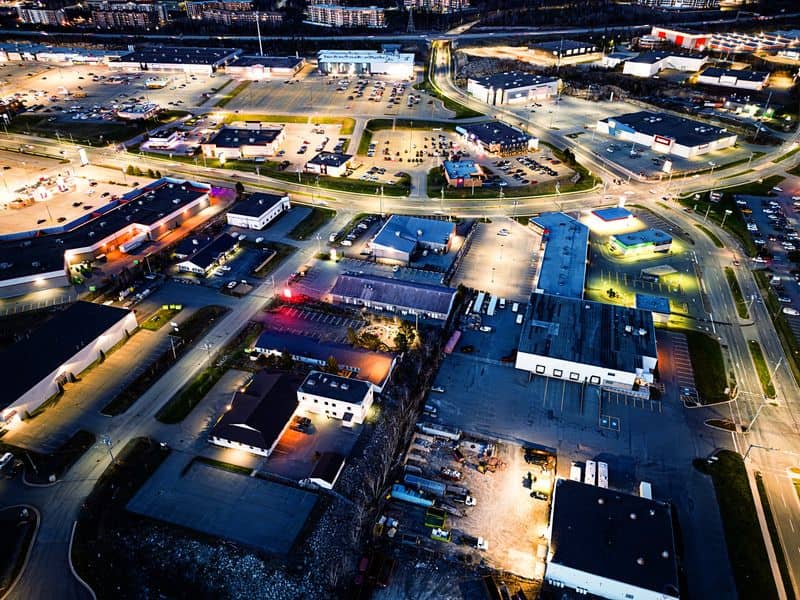

Fort Worth Land Surveying Posted on September 28, 2026 by Fort WorthSurveyorSeptember 24, 2026
Aerial view of commercial pad sites and shared access areas in Fort Worth, Texas.

A shopping center parking lot often has a corner nobody uses. That strip near the road could hold a bank, a coffee shop, or a quick-service restaurant. Before it can be sold, leased, or financed on its own, though, it needs its own legal lot lines.

That change happens through a replat. A replat redraws the lots on an existing recorded plat, and a land survey supplies the data behind every new line. Bring your surveyor in before you sign a pad sale or ground lease, because access, easements, and parking often decide where those lines can go.

How Replats Divide Commercial Property Into Separate Pad Sites

A replat is a revised version of a recorded plat that changes lot lines, adds lots, or updates easements. For commercial pads, it usually carves one or more small lots out of a larger parent tract. Each new lot gets its own legal description, so it can be sold, leased, mortgaged, and taxed separately.

The process follows a fairly set order. The exact steps can vary by city, county, and project type. Most commercial replats move through these stages:

  • A boundary survey of the parent tract
  • A draft layout of the new pad lots
  • Review by planning staff and any required boards
  • Revisions, approval, and recording of the final plat

Some owners try to skip the replat and describe the pad by metes and bounds in a deed. Many local codes don’t allow that kind of split without platting, and title companies or lenders may refuse to insure it. A surveyor and a real estate attorney can tell you which path your city requires.

Boundary and Easement Data Needed Before Replatting

A replat starts with a current boundary survey of the entire parent tract. The surveyor locates monuments, checks the recorded plat, and compares deeds and neighboring records. Gaps, overlaps, or encroachments need to be found now, because they’re much harder to fix once new lots exist.

Easements matter just as much. Utility lines, drainage channels, fire lanes, and shared driveways often cross the exact spot where a pad would sit. The surveyor reviews the title commitment and recorded documents so each easement shows up on the drawing.

Documents to Gather Early

Your surveyor will move faster with good records in hand. Missing documents are one of the most common causes of delay. Pull together what you can before the kickoff call:

  • A title commitment with copies of the recorded exceptions
  • The existing recorded plat and current deeds
  • Any reciprocal easement agreement or declaration for the center
  • Prior surveys, site plans, or as-built drawings

Shopping centers often have a reciprocal easement agreement that controls parking, access, and building areas. A new pad can conflict with those terms even when the lot lines work on paper. Share the agreement with your surveyor and attorney early so the layout respects it.

How Surveyors Coordinate New Lot Lines and Access

New pad lines have to work for the pad buyer and for the center that stays behind. The surveyor works with the owner, the civil engineer, and often the buyer’s team to test where lines can fall. A line that looks fine on a sketch can leave a pad without legal access or drop the remaining center below its required parking.

Most pads don’t have their own driveway onto a public street. They rely on shared drives through the larger site. The replat or a separate recorded agreement should spell out cross-access and cross-parking rights so every lot can legally reach the road.

Questions to Settle Before the Lines Are Final

A few details cause most of the rework on pad replats. Settling them early keeps review cycles shorter. Work through these with your design team:

  • Where each pad gets its driveway and cross-access
  • Whether the parent tract still meets parking and setback rules
  • Which utilities serve the pad and where new easements are needed
  • How storm water from the pad reaches the existing drainage system

Setback, frontage, and minimum lot size rules can vary by zoning district. Your surveyor can flag likely problems, but the planning office has the final word. Ask for a pre-application meeting if your city offers one.

Topographic and Site Data That Support Pad Development

A topographic survey maps the ground surface, including elevations, slopes, and existing features. Pad developers need this data to plan grading, drainage, and building floor heights. It also shows curbs, light poles, utility structures, and trees that may need to move.

Drainage is often the biggest surprise on a pad site. Many shopping centers were built with one detention system for the whole property. If a new pad adds pavement or roof area, the engineer needs accurate elevations to show whether that system can handle the extra runoff.

Floodplain status deserves a check too. If any part of the pad sits near a mapped flood zone, the surveyor can show that line on the drawing and note flood elevations where they apply. Lenders and insurers may ask for this before closing.

Final Plat Documentation for Separate Commercial Parcels

The final plat is the recorded drawing that makes the new pad lots official. It typically shows lot lines, bearings and distances, lot areas, easements, right-of-way, and required notes and certificates. Once it’s recorded, each pad carries its own legal description.

Recording isn’t always the last survey step. Buyers and lenders often ask for a new survey of the individual pad after the plat is filed, sometimes an ALTA/NSPS land title survey. Build that into your schedule, since closings often depend on it.

Keep the recorded plat, survey files, and access or easement agreements in one place. Future tenants, lenders, and contractors will ask for them. Good records also make the next replat faster if the center adds more pads later.

Frequently Asked Questions

How long does a commercial replat take?

Timing varies widely by city, project size, and how clean the records are. Simple replats may wrap up in a few months, while complex ones with easement issues can take longer. Review cycles and board meeting dates often set the pace more than field work does. Start the land survey early so it doesn’t become the holdup.

Do I need a new boundary survey if I already have one?

It depends on how old the survey is and what has changed on the site. Most cities and title companies want current field data for a replat. An older survey can still help the surveyor research the property faster. Ask your surveyor to review it and tell you whether an update will work.

Can a pad site share parking with the shopping center?

Yes, shared parking is common for commercial pads. That right usually comes from a recorded easement or agreement, since plat lines alone don’t create it. Local rules may also limit how many shared spaces each lot can count. Confirm the details with your attorney and planning staff before the plat is final.

Posted in land surveying | Tagged Land Surveying
